Enhanced geothermal has spent years in the category of promising energy technology. Fervo now has a larger physical proof point. The first 33-megawatt GeoBlock at Cape Station in Utah is synchronized to the grid and exporting electricity, moving the project from drilling and construction into actual power generation.1

IN BRIEF

Fervo says the first 33 MW GeoBlock at Cape Station is exporting electricity to the grid. Phase I is about 100 MW, roughly 900 MW of Cape Station offtake is contracted, and another 400 MW phase is under construction. First power is an operating milestone, but it is not the same as full commercial operation of the whole project.1, 2, 3

Cape Station moves from plans to operating megawatts. First GeoBlock: 33 MW — First Cape Station GeoBlock exporting electricity as of September 24, 2026.. Phase I: ~100 MW — Three 33 MW GeoBlocks in Cape Station Phase I.. Contracted offtake: ~900 MW — Approximate Cape Station capacity Fervo says is fully contracted, not all operating today.. 3 of 4 entries shown. Values and their context are also available as HTML below.
Cape Station moves from plans to operating megawatts. 3 of 4 entries shown. Values and their context are also available as HTML below.1

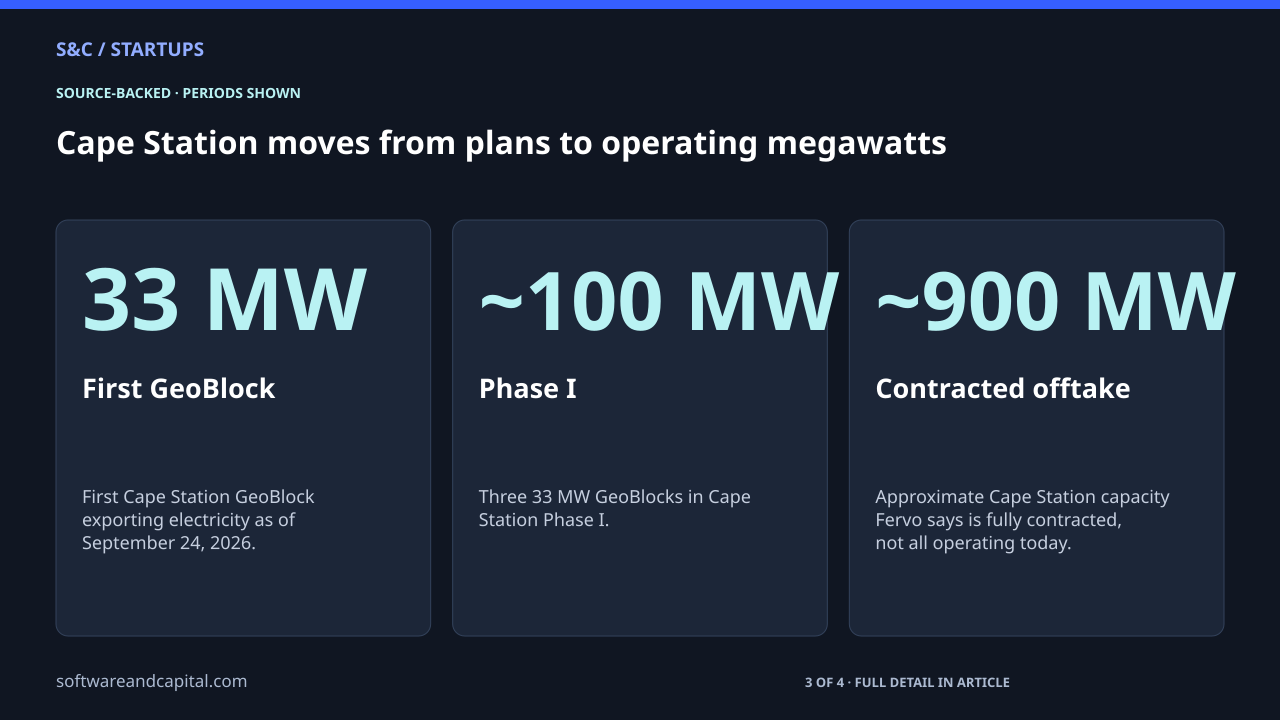

Cape Station moves from plans to operating megawatts

33 MW
First GeoBlock1

First Cape Station GeoBlock exporting electricity as of September 24, 2026.

~100 MW
Phase I1

Three 33 MW GeoBlocks in Cape Station Phase I.

~900 MW
Contracted offtake1

Approximate Cape Station capacity Fervo says is fully contracted, not all operating today.

~4.3 GW
Capacity potential3

Cape Station capacity potential disclosed in Fervo's 2026 IPO prospectus.

Horizontal drilling is the core technology shift

Traditional geothermal projects depend on locations where underground heat and natural permeability line up conveniently. Fervo uses horizontal drilling, multistage stimulation and subsurface monitoring techniques adapted from oil and gas to create controlled flow paths through hot rock. Its goal is to make geothermal development less dependent on rare naturally favorable reservoirs.1, 3

The Cape Station timeline is a series of different milestones1, 3
StageStatusWhat it means
First GeoBlockFirst power achievedElectricity is flowing to the grid while the unit ramps toward contractual commercial operation.
Remaining Phase I unitsCommissioningTwo more GeoBlocks are expected to reach contractual commercial operation by January 1, 2027.
Phase IIUnder constructionAn additional 400 MW is planned for commercial operation in 2028.
Longer-term Cape StationDevelopment potentialFervo has disclosed about 4.3 GW of total capacity potential, much of it not yet operating.

First power is not full commercial operation

The first unit is generating electricity, but Fervo says its contractual commercial-operation date comes after commissioning and ramp-up. The remaining Phase I blocks are still being commissioned. That distinction matters because a project can be physically online before every contractual performance condition has been met.1

The demand side is already unusually visible

Fervo says roughly 900 MW of Cape Station offtake is fully contracted. An August SEC filing describes a 396 MW power purchase agreement with Google, delivered in four 99 MW tranches beginning in 2028, plus a possible expansion option that could push Google's contracted capacity higher if a later agreement is reached.1, 2

Contracted capacity is not the same as operating capacity. It does show that buyers are willing to sign long-term agreements before all of the generation assets are complete. For a capital-intensive power project, those contracts can matter as much as a technology demonstration because they support financing and construction decisions.

The comparison is with firm power, not only solar and wind

Enhanced geothermal is attractive because it can produce electricity around the clock rather than only when the sun shines or wind blows. That does not make it universally cheaper or easier to build. It makes it a different type of grid resource, especially for large loads that value continuous supply.1

What still has to happen after first power

  • Ramp the first GeoBlock to contractual commercial operation.
  • Finish commissioning the remaining Phase I units.
  • Complete the 400 MW Phase II build on its planned schedule.
  • Convert longer-term capacity potential into financed, permitted and operating projects.

S&C's AI electricity constraint analysis explains why power availability has become a technology-business bottleneck. Cape Station is the supply-side counterpart: one new generation method is beginning to move from pilot projects into utility-scale construction and contracted delivery.

The important milestone is narrower than saying enhanced geothermal has solved the power problem. One 33 MW block is now producing electricity. If the rest of Cape Station follows, the story becomes how quickly that engineering approach can be repeated at hundreds and eventually thousands of megawatts.

Sources and methodology

Sources checked September 28, 2026. Dates and periods for individual figures are stated beside them.

  1. GlobeNewswire: Fervo Energy announces Cape Station first power ↗Accessed 2026-09-28
  2. Fervo Energy: August 2026 Google PPA filing ↗Accessed 2026-09-28
  3. Fervo Energy: 2026 IPO prospectus ↗Accessed 2026-09-28
Scope and assumptions

Fervo's claim that Cape Station is the first utility-scale greenfield enhanced geothermal development to reach first power is company framing and is not independently adjudicated here.

Only the first 33 MW GeoBlock has reached first power. Most contracted and potential Cape Station capacity is not operating today.

Future commercial-operation dates, expansion options and long-term capacity are forward-looking and can change.

Continue reading

AI’s Next Constraint May Be Electricity, Not Intelligence →

Two Weeks to Hours: AWS Is Using AI Agents to Speed Grid Connections →

The AI Data-Center Boom Has a Picks-and-Shovels IPO: Accelevation Revenue Rose 176% →
